4000 Chamisa Dr — Interior Remodel

Scope and finish specifications · Austin, TX 78730 · September 22, 2026

Phase 1 scope

  1. Smooth walls and ceilingsLiving areas, upstairs bedrooms, closets, halls and entry.
  2. Replace baseboards and door casingNew baseboards and casing at doors and cased openings. Window trim deferred until replacement windows are installed.
  3. Remove crown moldingIn included rooms.
  4. Paint walls, ceilings, doors and trimIncludes all three bathrooms. Paint colors and finishes below.

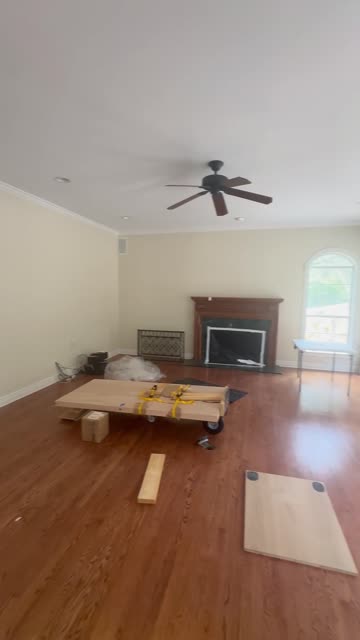

  5. Replace stair treads, risers and railingWood steps and railing with black metal balusters. Details and photos below.
  6. Replace fireplace surround, hearth and mantelNew limestone surround and wood mantel. Limestone selection pending. Design shown below.
  7. Replace upstairs carpet and padBedrooms, closets and hallway.
  8. Replace downstairs flooringNew engineered hardwood, including kitchen and downstairs bathroom. Laundry room and downstairs bedroom excluded.
  9. Replace interior doors and hardwareNew painted interior doors and hardware. Details and photos below.
  10. Remove office and upstairs closet built-insAll built-ins in these rooms, including the office gun case.
  11. Replace can lights; remove fans and hanging lightsReplace can lights (6″ LED, 2700K, white trim). Remove ceiling fans and hanging light fixtures in included rooms. Keep the existing electrical boxes and wiring for new fixtures to be installed later. Remove entry/upstairs-hall sconces. Kitchen lighting is Phase 2.

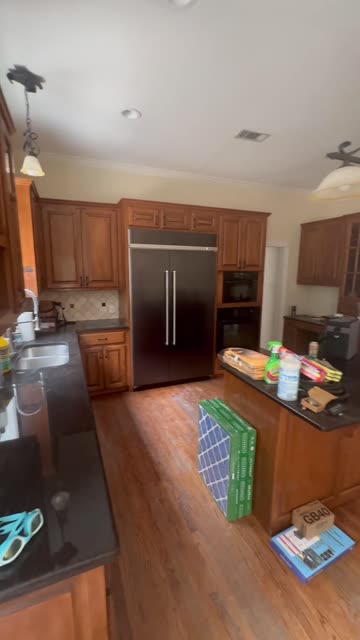

Kitchen — Phase 1: demolition and hardwood flooring.

Kitchen — Phase 2: build-out, cabinetry, countertops, backsplash, wall and ceiling finishing, and paint. Design is still in progress.

Windows and sliding door — Phase 2: remove the existing eyebrow/arched window tops and install rectangular replacement windows; replace the living-room door and eyebrow above it with a new sliding glass door. Final drywall at these openings follows the Phase 2 changes. Front entry remains with the window scope.

Drywall smoothing exclusions: bathrooms and pantry, in addition to the two rooms excluded above. Kitchen finishing is Phase 2.

Floor plans

Click images to enlarge.

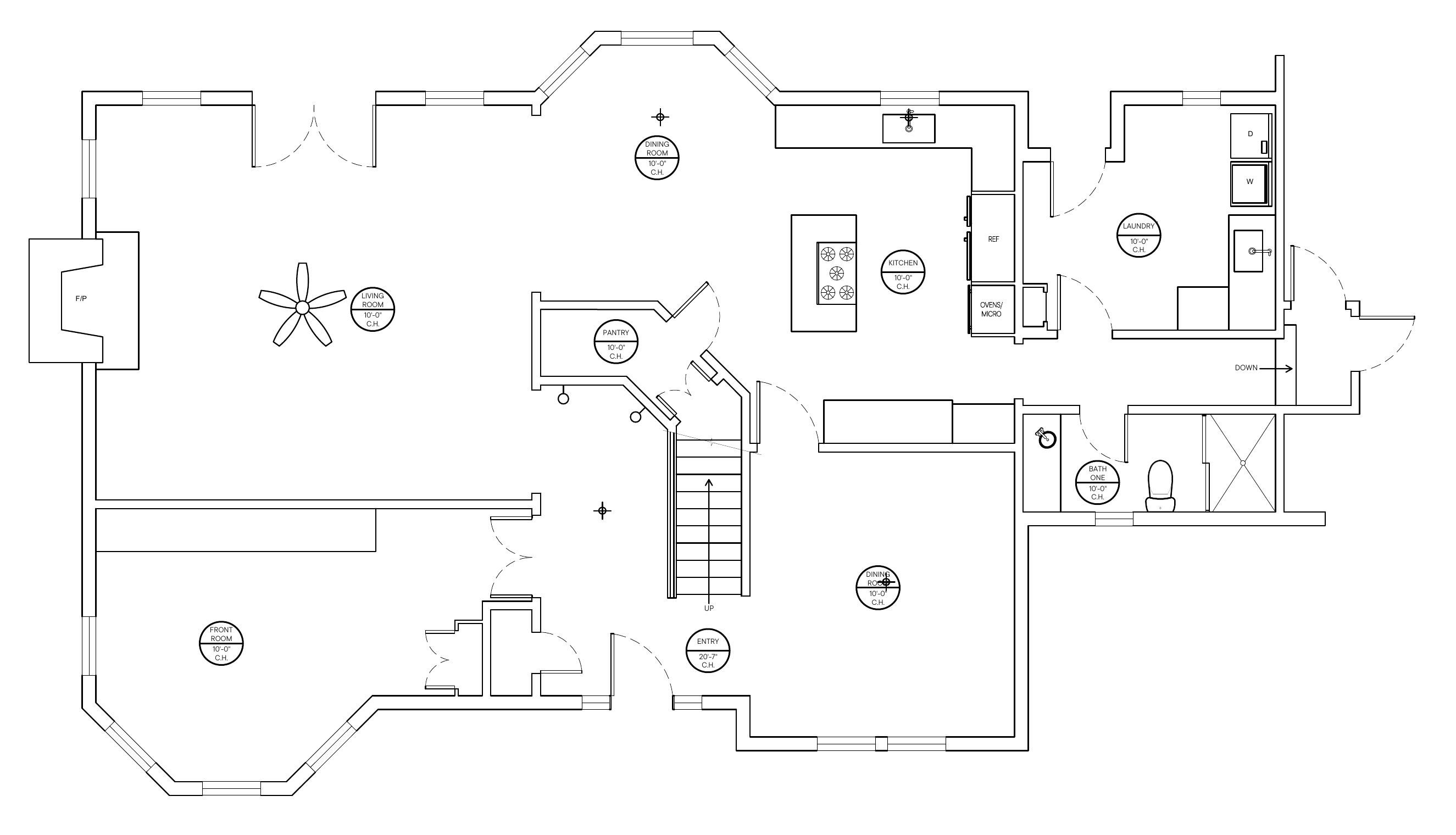

Downstairs floor plan showing living room, kitchen, dining room, office, entry, stairs, bathroom and laundry
DownstairsOffice is labeled “Front Room.”

Laundry room excluded. The downstairs bedroom is not shown and is also excluded from all work.

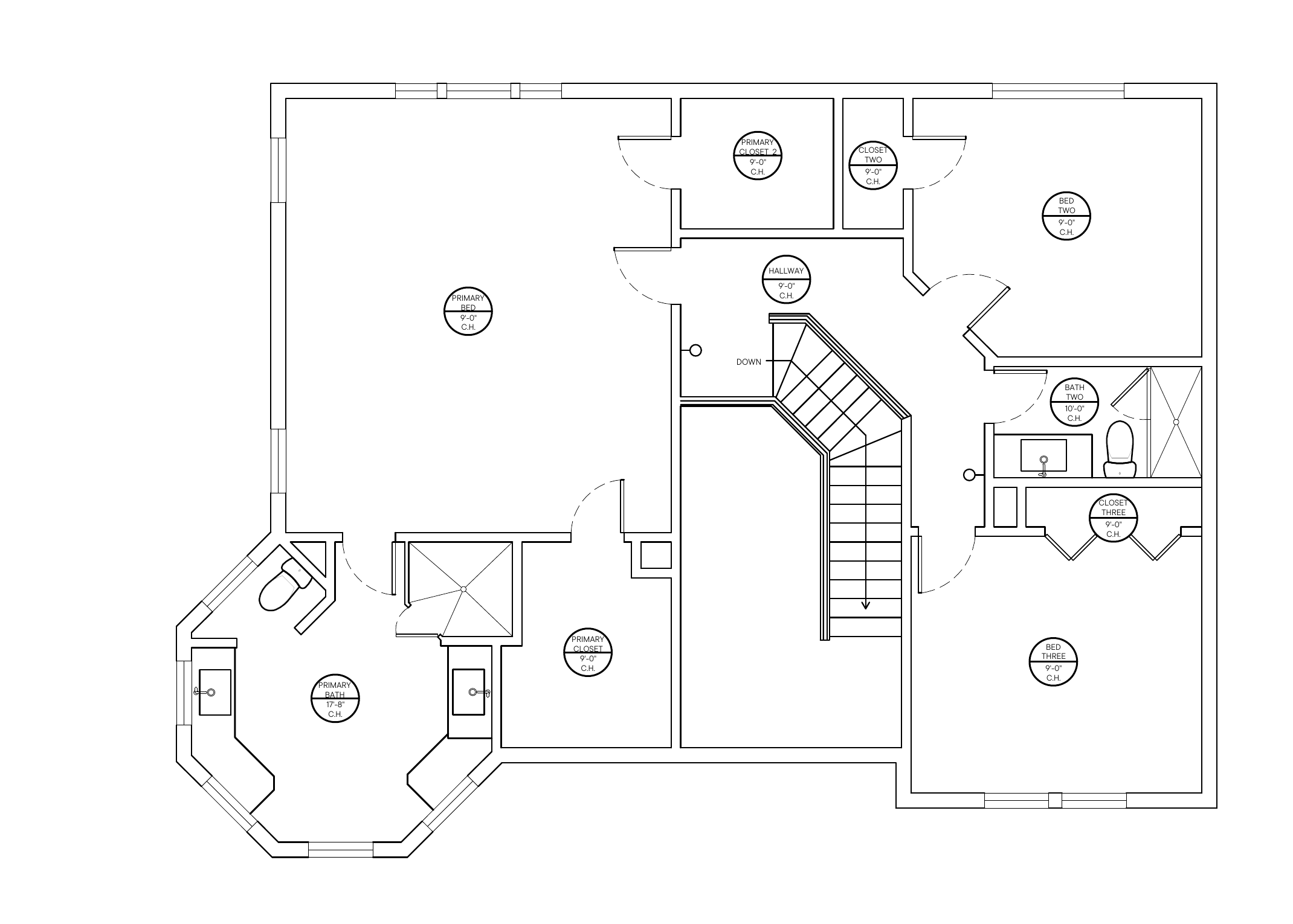

Upstairs floor plan showing bedrooms, closets, bathrooms, hallway and stair opening
UpstairsBathroom flooring remains.

Trim and interior doors

Painted baseboard with a routed top edge

Baseboards

6″ tall

Paint-grade, routed top edge.

Shoji White · semi-gloss

Flat painted door casing with a square profile

Door and opening casing

4″ × 1″

Flat stock, paint-grade.

Shoji White · semi-gloss

Painted interior door style reference

Interior doors

Painted doors in the style shown. Prefer doors ordered in this style; adding moulding is an alternative.

Detail reference: ½″ moulding, 6″ inset, mitered corners.

Shoji White · semi-gloss

Moulding profile ↗
Brass lever on a rectangular backplate

Hardware: owner-supplied brass levers; model pending.
Office doors: design pending.

Paint

Zero-VOC water-based or low-VOC oil-based paint.

White Dove

Benjamin Moore · OC-17

  • Walls: washable matte / flat.
  • Bathroom and closet walls: satin.
  • Ceilings: flat.

Shoji White

Sherwin-Williams · SW 7042

  • Doors, baseboards and casings: semi-gloss.

Screen colors are approximate.

Flooring

Natural wood tone from the design palette

Downstairs hardwood

Opus · Signature Series · Venice Bay
Engineered hardwood · ⅝″ thick × 9½″ wide.

Glue-down to slab after removal of existing flooring and plywood underlayment.

Includes kitchen and downstairs bathroom.

Excluded: laundry room and downstairs bedroom.

Neutral carpet texture from the design palette

Upstairs carpet

Karastan · Tower View · Atrium
Sample and pad selection pending.

Bedrooms, closets and hallway. Existing bathroom flooring remains.

Images show color and texture references, not verified product swatches.

Stairs

Wood tone to match downstairs flooring.

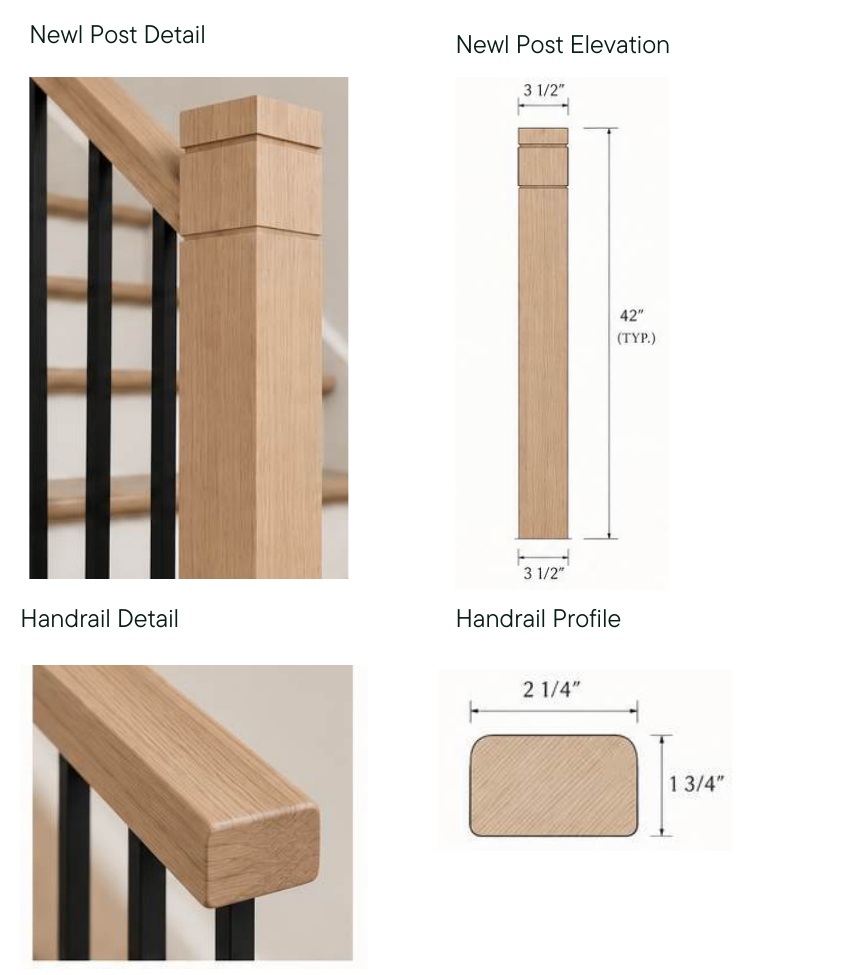

Selected stair details

Wood stair treads and wood risers

Treads and risers

Wood treads and wood risers with square nosing.

Nosing profile

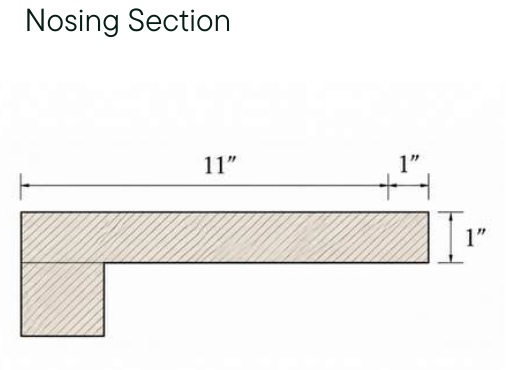

Square stair nosing section and dimensions

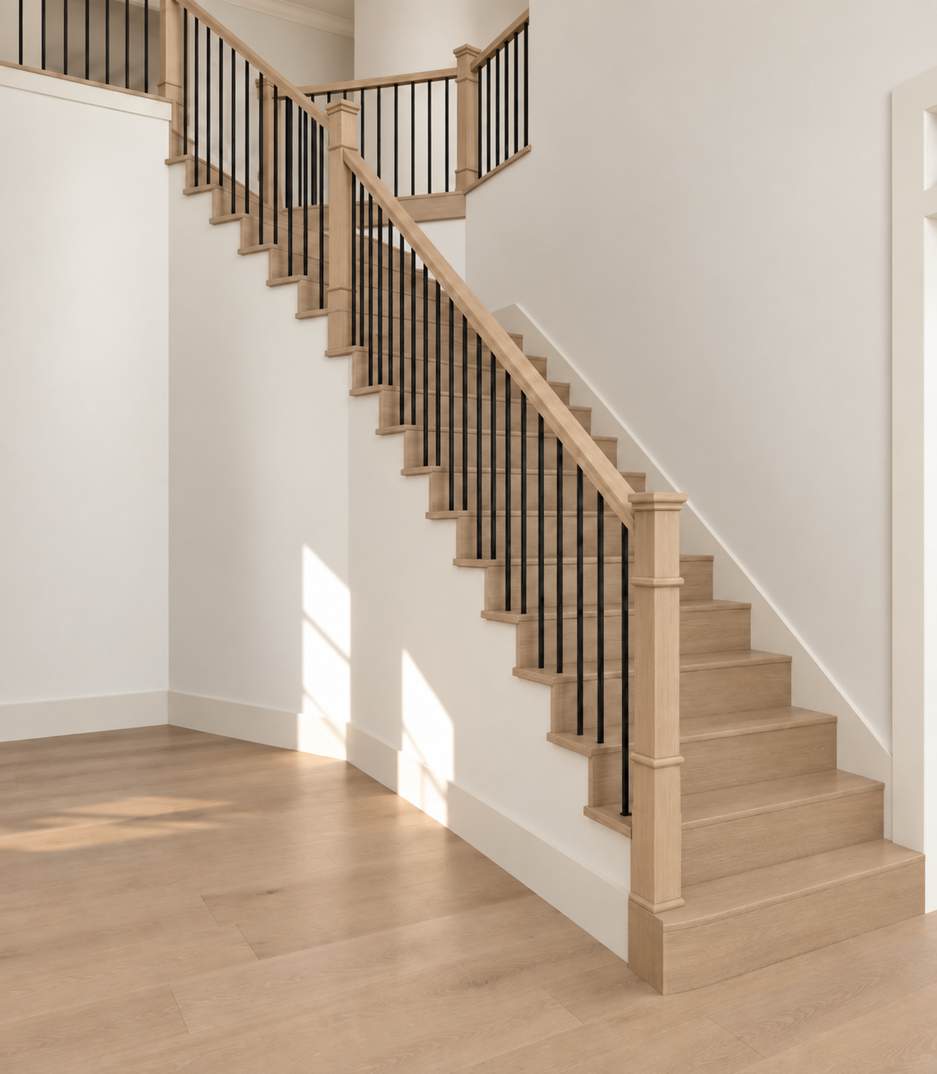

Wood handrail, square newel posts and straight black metal balusters

Railing

Wood handrail and square newel posts with straight black metal balusters.

Fireplace

Detailed stone fireplace surround with wood mantel and Roman clay above

Limestone surround

Stepped limestone surround, wood mantel and Roman clay finish above, in the form shown.

Limestone selection pending. Final stone will differ from the rendering.

Window change: the arched top shown will be replaced with a flat, rectangular top in Phase 2.

House videos

Existing conditions · September 4, 2026

Discussion with contractor

How can we complete Phase 1 and move in as soon as possible, then do the windows and exterior doors in Phase 2 without doing the same work twice?

For example, if we finish the drywall returns around the existing windows and fully paint the walls now, replacing the windows later could mean redoing those returns and repainting the walls. We want to avoid paying for that work twice.

Would it make more sense to leave those areas primed only, or apply the first coat of paint and leave the second coat until after the new windows are installed? How much of the drywall work around the openings should wait?

The same question applies to the exterior doors, which we will also replace in Phase 2. We’d like to work out what can be finished for move-in and what should wait.

Phase 2 — Design in progress

Kitchen

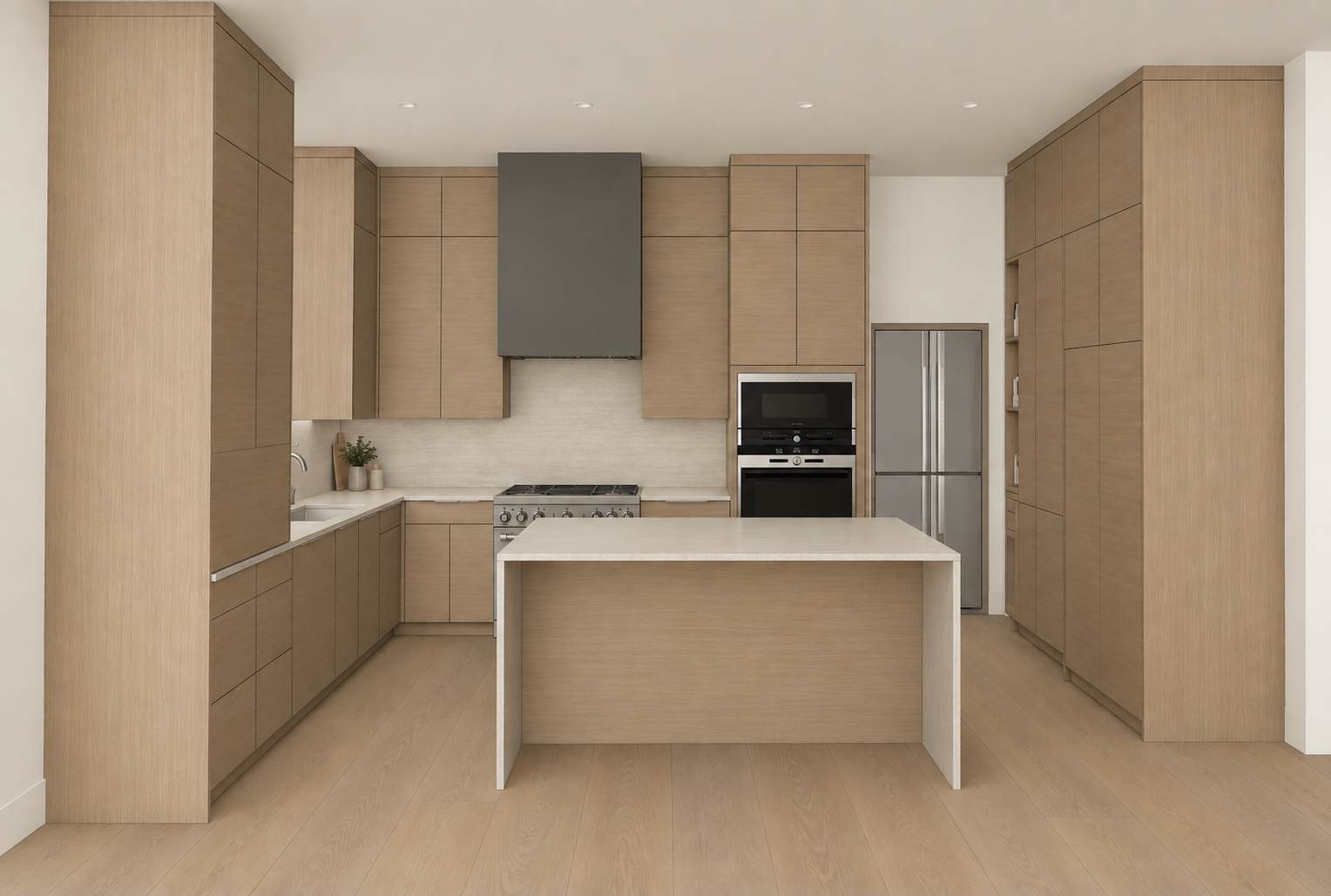

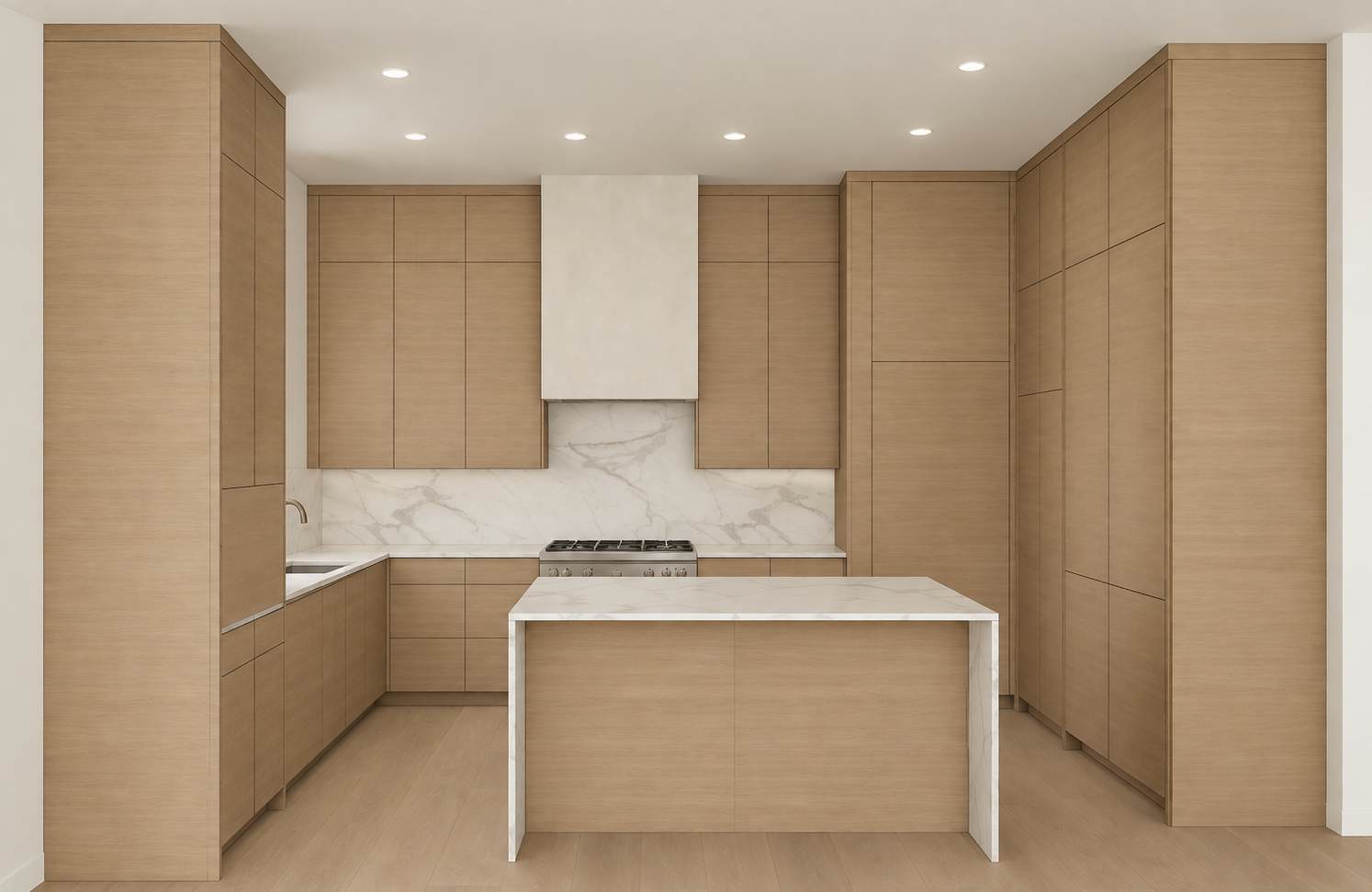

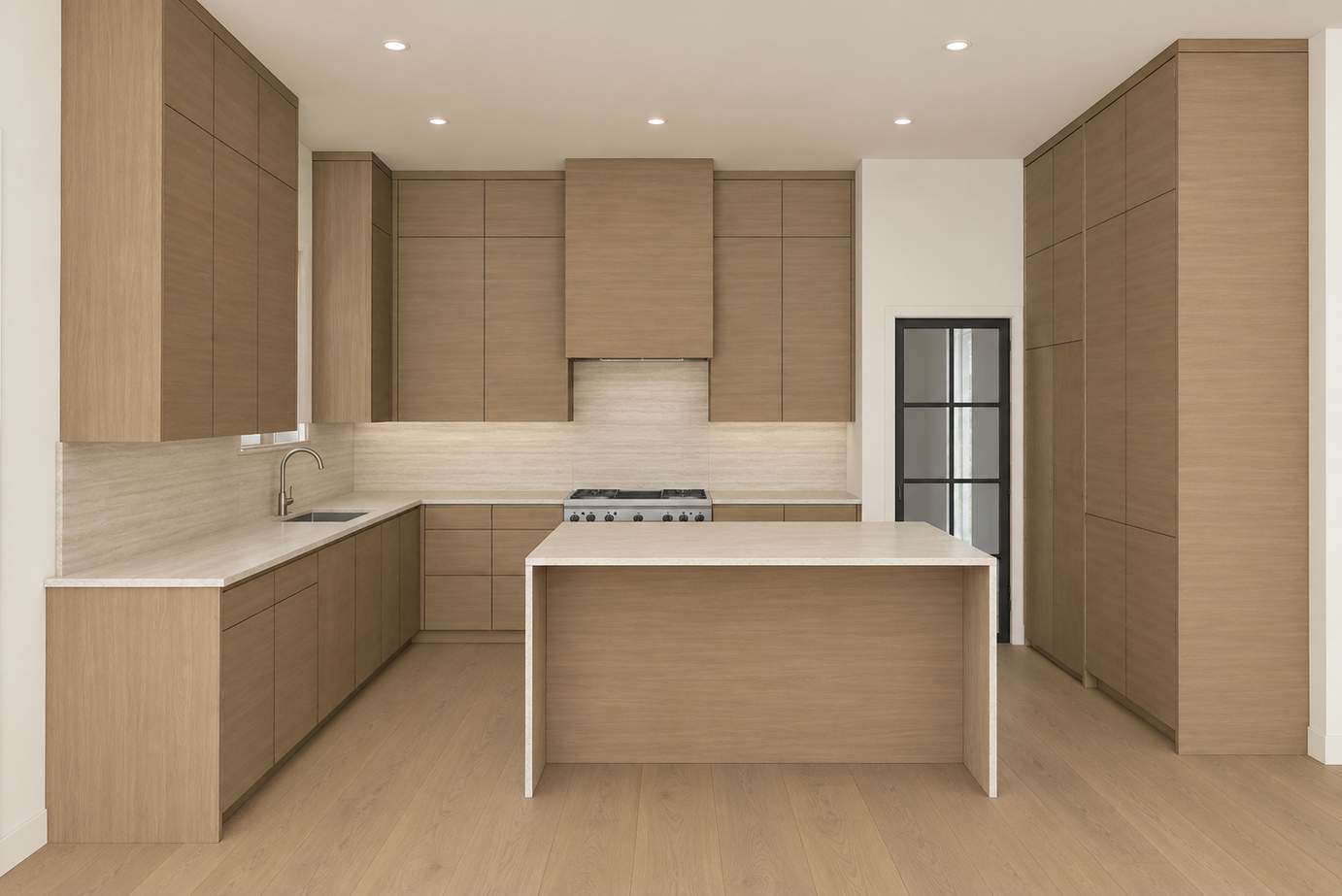

Kitchen planning is still in progress. Elevations are expected to be finalized soon. These are the current design options; no option is finalized.

Phase 1: kitchen demolition and flooring. Phase 2: kitchen build-out, lighting, final drywall and paint.

Windows, sliding door and front entry

Windows in included rooms: black frames with divided lights, as shown. Remove the existing eyebrow/arched tops and convert to flat, rectangular openings. Final products and dimensions pending.

Replace door and eyebrow above door with a new sliding glass door. Living room; final size and opening dimensions pending.

Front entry: replacement planned with the window work; design pending.

Drywall coordination: final returns, adjacent patching and paint at these openings are Phase 2, after the window and sliding-door changes. Window trim remains deferred.

Image reference

Full size ↗

House video
